The Prospector News

Koryx Copper Announces Further Positive Drill Results at the Haib Copper Project, Southern Namibia

You have opened a direct link to the current edition PDF

Open PDF Close
Uncategorized

Share this news article

Koryx Copper Announces Further Positive Drill Results at the Haib Copper Project, Southern Namibia











Highlights

• Assays reported for a further 17 drill holes for 5,556m of diamond drilling.
• Results received are consistent and confirm mineralisation in the Target areas with Cu grades in line with and in some cases above the average mineral resource estimate:
• Best intercepts received are as follows:
• HM96: 40m @ 0.37% Cu (4 to 44m)
  116m @ 0.36% Cu (228 to 344m)
• HM76: 50m @ 0.33% Cu (102 to 152m)
  7m @ 0.37% Cu (216 to 223m)
• HM78: 36m @ 0.33% Cu (86 to 122m)
• HM79: 96m @ 0.31% Cu (74 to 170m)
• HM81: 12m @ 0.49% Cu (182 to 194m)
• HM83: 34m @ 0.35% Cu (10 to 44m)
• HM84: 38m @ 0.33% Cu (4 to 42m)
• HM86: 30m @ 0.33% Cu (68 to 98m)
  92m @ 0.32% Cu (252 to 344m)
• HM91: 52m @ 0.36% Cu (18 to 70m)
  46m @ 0.34% Cu (126 to 172m)
• HM100: 30m @ 0.33% Cu (180 to 210m)
  10m @ 0.48% Cu (374 to 384m)
• Four additional man portable rigs have arrived in Namibia and are in transit to the site and will commence drilling in October, bringing the total rig count to eight rigs on the resource drill program and 2 rigs on Geotech drilling.
• Relogging and geological interpretation focussed on lithology, structure and modelling of Mo and Au by-products was completed and is currently being used for updated models.


Koryx Copper Inc. (TSX-V: KRY) is pleased to announce assay results from 17 drill holes (5,556m) received as part of the Phase 2 and 3 drill program for its 2025 exploration and project development strategy on the wholly-owned Haib Copper Project in southern Namibia. Haib is an advanced-stage Cu/Mo/Au project that is envisaged to produce a copper concentrate via a conventional crushing/milling/flotation metallurgical process, with the potential for additional copper production via heap leaching.



Heye Daun, Koryx Copper’s President and CEO commented: “The recent batch of 17 assay results represents a good spread of locations across the entire mineralised system, and from each of the four defined Target areas. Encouragingly, the holes continue to yield consistently positive results and support the mineral resource at Haib. The site geological team has made notable progress with building an updated geological model, having completed the relogging of all available drill core, updated the database, and under the guidance of our expert consultants, have reinterpreted the entire lithological and structural model for the deposit.



We are now integrating all this information and with this updated geological model we now have a much better understanding of the controls and distribution of copper and molybdenum grade. The new model also allows the geologists to improve, and more accurately estimate, the overall mineral resource. These updated models are currently being reviewed with the intention of updating and publishing the updated MRE before the end of 2025, aiming to realise the upside from the drill results received since the previous estimate in August 2024”.

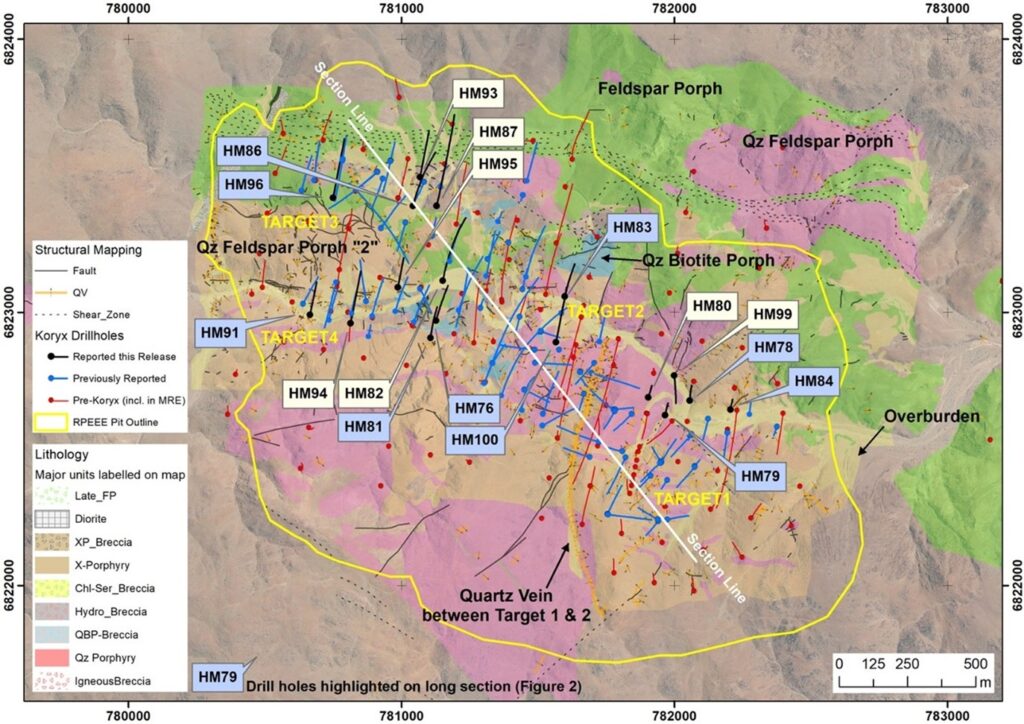

 Figure 1: Plan view indicating the seventeen recent drill hole locations. The holes indicated in blue are shown on the long section below

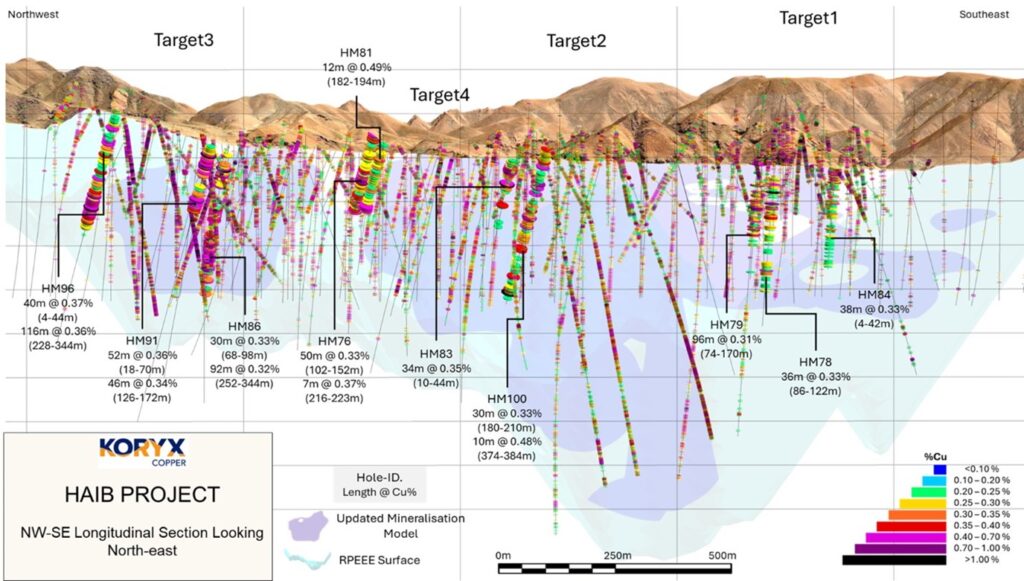

Figure 2. Long section looking northeast showing ten selected holes of the reported 17 hole intersections relative to the model for Cu mineralization



Discussion of Drill Results



Target 1 Results:

Recent results at Target 1 have further refined the mineralisation model. HM78 and HM79, drilled northwards from the Volstruis River, confirmed the shallow-dipping copper mineralisation with results consistent with expectations. However, HM99, drilled north of HM79 on the same section line, returned lower grades, indicating that mineralisation does not extend as far north as previously modelled—likely due to an unrecognised fault. HM80, located 40m west of HM79, confirmed the expected narrowing of mineralisation near the Quartz Vein boundary with Target 2, showing it occurs further south than predicted and suggesting a small reduction in tonnage. HM84, drilled 150m east of HM78, successfully closed sample spacing and delivered results in line with the current model, strengthening confidence in continuity.



Target 2 Results



Drilling at Target 2 continues to confirm strong copper mineralisation. HM83, drilled northwards from the Volstruis River, outlined the northern limit of the zone with 34m of well-developed near-surface copper, including 8m at 0.64% Cu, and a second mineralised interval from 64m to 80m. Grades taper off below 80m, helping define the depth extent of mineralisation in this area. HM100, drilled centrally, successfully closed spacing and returned results in line with expectations, further strengthening confidence in continuity across the target.



Target 3 Results



Drilling at Target 3 has provided further definition of mineralisation controls and boundaries. HM86, drilled near the northeastern edge, confirmed copper within porphyritic andesites, with grades increasing at a shallower depth than predicted by the model. HM87, located 90m east of HM86 where Target 3 overlaps with Target 2, returned lower than expected grades, with the anticipated broad >0.2% Cu zone absent—likely due to faulting or a local change in dip towards the northeast. HM93, drilled along the northern edge, refined the position of the shear zone that defines the mineralisation boundary, showing it to be slightly further south than modelled. HM96, drilled in the west, successfully closed spacing in this area with results consistent with expectations, strengthening confidence in continuity.



Target 4 Results



Drilling at Target 4 has confirmed extensions of mineralisation and highlighted areas of potential tonnage gain. HM76, drilled between Targets 2 and 4 along the Volstruis River, intersected strong copper and molybdenum mineralisation, including >200 ppm Mo over 160m with multiple samples exceeding 2,000ppm. HM81, drilled down dip, correlated well with HM76 at depth, confirming continuity of the deeper Cu-Mo zones. HM82, drilled north of HM76 across the river structure, returned low near-surface grades but showed increasing copper and scattered high-grade molybdenum at depth. Infill holes HM91 and HM94, drilled in the centre of the target, generally aligned with the model, though HM91 revealed a 46m zone averaging 0.34% Cu outside the current high-grade domain, indicating wider-than-expected mineralisation, while HM94 returned slightly lower-than-forecast copper due to porphyritic andesite dominance as opposed to breccia, which is more typical here. HM95, on the eastern edge, intersected deeper copper zones beyond the model, representing a potential tonnage increase.



Table of Significant Intersections



Hole# Zone From (m) To (m) Width (m)1 Cu (%) Mo (%) Au (g/t)
HM76 Entire Hole 1 223 221 0.24 0.015 0.017
Main 1 22 21 0.34 0.004 0.016
Main 102 152 50 0.33 0.022 0.024
Including 124 136 12 0.47 0.062 0.029
Main 174 202 28 0.31 0.013 0.018
Main 216 223 7 0.37 0.005 0.03
HM78 Entire Hole 0 369 369 0.21 0.001 0.026
Main 60 62 2 3.75 0.002 0.184
Main 86 122 36 0.33 0.001 0.039
Main 240 250 10 0.31 0.004 0.041
HM79 Entire Hole 0 270 270 0.2 0.001 0.03
Main 2 6 4 0.55 0.004 0.026
Main 74 170 96 0.31 0.002 0.044
Including 102 110 8 0.78 0.011 0.057
HM80 Entire Hole 0 260 260 0.14 0.001 0.027
Main 0 14 14 0.36 0 0.068
HM81 Entire Hole 0 220 220 0.19 0.012 0.015
Main 182 194 12 0.49 0.011 0.033
HM82 Entire Hole 0 506 506 0.12 0.004 0.016
Main 206 212 6 0.41 0.004 0.028
Main 250 268 18 0.31 0.01 0.035
HM83 Entire Hole 0 195 195 0.19 0.001 0.011
Main 10 44 34 0.35 0.002 0.017
Including 28 36 8 0.64 0.005 0.026
Main 64 80 16 0.41 0.002 0.019
HM84 Entire Hole 0 240 240 0.23 0.002 0.024
Main 4 42 38 0.33 0.001 0.034
Including 12 20 8 0.46 0.002 0.043
Main 82 88 6 0.37 0.001 0.035
HM86 Entire Hole 0 425 425 0.19 0.001 0.017
Main 68 98 30 0.33 0.002 0.03
Including 76 82 6 0.62 0.004 0.073
Including 94 96 2 0.58 0.002 0.032
Main 184 216 32 0.3 0.001 0.028
Including 214 216 2 0.59 0.003 0.033
Main 252 344 92 0.32 0.002 0.021
HM87 Entire Hole 0 615 615 0.09 0.001 0.025
HM91 Entire Hole 0 246 246 0.2 0.002 0.017
Main 18 70 52 0.36 0.005 0.019
Including 20 26 6 0.69 0.002 0.02
Including 46 58 12 0.61 0.001 0.018
Main 126 172 46 0.34 0.004 0.019
HM93 Entire Hole 0 320 320 0.08 0.001 0.01
Main 106 116 10 0.3 0.001 0.009
HM94 Entire Hole 0 389 389 0.14 0.008 0.014
Main 148 166 18 0.32 0.044 0.014
HM95 Entire Hole 0 223 223 0.2 0.005 0.01
Main 20 26 6 0.56 0.001 0.031
Main 38 48 10 0.31 0.001 0.016
Main 168 174 6 0.31 0.016 0.003
Main 202 223 21 0.31 0.014 0.011
HM96 Entire Hole 0 441 441 0.22 0.003 0.013
Main 4 44 40 0.37 0.005 0.017
Including 12 18 6 0.51 0.007 0.019
Including 34 40 6 0.61 0.002 0.028
Main 228 344 116 0.36 0.004 0.02
Including 270 276 6 0.57 0.001 0.036
Including 282 290 8 0.54 0.002 0.027
Including 302 308 6 1.27 0.006 0.041
HM99 Entire Hole 0 202 201 0.16 0.002 0.047
Main 130 132 2 2.09 0.027 0.027
Main 168 170 2 0.91 0.016 0.069
HM100 Entire Hole 2 413 411 0.21 0.004 0.014
Main 180 210 30 0.33 0.007 0.022
Including 182 186 4 0.66 0.016 0.027
Main 338 346 8 0.3 0.001 0.019
Main 374 384 10 0.48 0.008 0.029
Including 382 384 2 1.27 0.028 0.072
  1. Widths are interval widths and not true widths. The reported intervals are calculated using the following parameters:
  2. Only % Cuwas used to determine the intervals
  3. The target composite grade is ≥0.30% Cu.
  4. Composites start and end with samples ≥0.30% Cu.
  5. Grades between 0.20% and 0.30% are included in interval but generally constitute <40% of the interval.
  6. Consecutive samples between 0.20% and 0.30% should be fewer than 5 samples (10m).
  7. Grades below 0.20% are included but generally constitute <20% of the interval.
  8. Consecutive grades <0.2% should be fewer than 2 samples (4m).



Resource Modelling Update



The large batch of results reported above have been extremely useful in providing the information to further define the structural complexity of the system, as well as updating both the lithological and mineralisation models, particularly in areas where significant faulting has been encountered. The full set of multielement assays and gold assays have now been added to the database for review and statistical analysis during the remainder of October, with the intention of producing an updated MRE by the end of the year.



The MRE update is expected to demonstrate the upside from the successful drilling campaigns on the copper resource and significant increase in the number of molybdenum assays for estimate, as well as the potential inclusion of gold for the first time as a discreet model.



The increased density of drill results throughout all areas of the mineralised system is also expected to improve the resource classification in the new block model by converting Inferred material to the Indicated category. The team expects that with a better understanding of the Inferred material that is expected to remain following the update, a detailed drill plan can then be developed to target converting the resource to Indicated category in preparation for the pre-feasibility study publication in 2026.



While the logging and core interpretation used to update the new geological models and MRE will assist with guiding the future drill planning in the different Target areas, with the arrival of four new drill rigs in October the team are looking forward to accelerating the drill program to execute the remaining program in the first half of 2026.



RSU Issuance



The Company has approved the grant of up to an aggregate of 4,135,000 restricted share units to certain key executives, officers, consultants and directors of the Company pursuant to the Company’s Omnibus Plan, of which 1/2 of the RSUs will vest 12 months from the date of issuance, and then one-quarter each after 18 and 24 months. Each RSU represents the right to receive, once vested, one common share in the capital of the Company for every RSU held, or the cash equivalent thereof based on the fair market value of the shares of the Company calculated in accordance with the terms of the Omnibus Plan.



The grant of RSUs is subject to any necessary regulatory approvals and requirements of the Exchange.



Quality Control



All drill core was logged, photographed, and cut in half with a diamond saw. Half of the core was bagged and sent to ALS Laboratories Ltd. in Johannesburg, South Africa for analysis (SANAS Accredited Testing Laboratory, No. T0387) and ActLabs in Canada, while the other half was quartered with one quarter archived and stored on site for verification and reference purposes while the other quarter will be used for metallurgical test work. 33 elements are analyzed by Induced Coupled Plasma (ICP) utilizing a 4-acid digestion and gold is assayed for using a 30g fire assay method. Duplicate samples, blanks, and certified standards are included with every batch and are actively used to ensure proper quality assurance and quality control The QA/QC frequency is 1 in 20 for each of blanks, duplicates and standards.



Qualified Person



Mr. Dean Richards Pr.Sci.Nat., MGSSA – BSc. (Hons) Geology is the Qualified Person for the Haib Copper Project and has reviewed and approved the scientific and technical information in this news release and is a registered Professional Natural Scientist with the South African Council for Natural Scientific Professions (Pr. Sci. Nat. No. 400190/08).Mr. Richards is independent of the Company and its mineral properties and is a Qualified Person for the purposes of National Instrument 43-101.



About Koryx Copper Inc.



Koryx Copper Inc. is a Canadian copper development Company focused on advancing the 100% owned Haib Copper Project in Namibia whilst also building a portfolio of copper exploration licenses in Zambia. Haib is a large, advanced (PEA-stage) copper/molybdenum porphyry deposit in southern Namibia with a long history of exploration and project development by multiple operators. More than 80,000m of drilling has been conducted at Haib since the 1970’s with significant exploration programs led by companies including Falconbridge (1964), Rio Tinto (1975) and Teck (2014). Extensive metallurgical testing and various technical studies have also been completed at Haib to date.



Additional studies are underway aiming to demonstrate Haib as a future long-life, low-cost, low-risk open pit, sulphide flotation copper project with the potential for additional copper production from heap leaching. Haib has a current mineral resource of 511Mt @ 0.33% Cu and 51 ppm Mo for 1,668kt of contained copper and 25.9kt contained Mo in the Indicated category and 308.9Mt @ 0.31% Cu and 40 ppm Mo for 949Mt of contained copper and 12.4kt contained Mo in the Inferred category (0.15% Cu cut-off).



Mineralization at Haib is typical of a porphyry copper deposit and it is one of only a few examples of a Paleoproterozoic porphyry copper deposit in the world and one of only two in southern Africa (both in Namibia). Due to its age, the deposit has been subjected to multiple metamorphic and deformation events but still retains many of the classic mineralization and alteration features typical of these deposits. The mineralization is dominantly chalcopyrite with minor bornite and chalcocite present and only minor secondary copper minerals at surface due to the arid environment.
