Cerrado Gold Inc. [TSX-V: CERT] [OTCQX: CRDOF] announces production results for the third quarter ended September 2025 from the Minera Don Nicolas Mine in Santa Cruz Province, Argentina. Full quarterly financial results are expected to be released prior to November 30, 2025.
Q3 Operating Highlights
Operational results for Q3 2025 showed an increase in production over the previous quarter (+21%), driven by higher production from the Calandrias Sur heap leach operation (+33%). With the second phase of the crushing expansion complete, both tonnage and recoveries (due to more consistent particle sizing) improved over the quarter. Operations also benefited from recent investments in additional fleet capacity; namely new trucks, loaders, and excavators, to support higher mining rates. The final updates to the crusher circuit, including the final installation of the agglomerator and additional conveyors, are set to be completed in Q4/25.
Production from stockpiled material via the CIL plant remained stable, with lower grades being supported by minor contributions from higher-grade material produced during the development of the underground access portals and ramp.
The underground development continued at a steady pace during the quarter, following a delay caused by the requirement for increased portal support and additional shotcrete needed in select areas. Three portals have now been developed and are expected to reach the production stopes in Q4. The introduction of higher-grade material from underground operations is expected to begin to add materially to CIL production from late October and continue to ramp up into 2026.
Due to the delay with the underground development noted above, the Company is anticipating a slight reduction to its underground production during Q4 and has thus revised its 2025 Production Guidance from 55,000 to 60,000 GEO to 50-55,000 ounces for 2025.

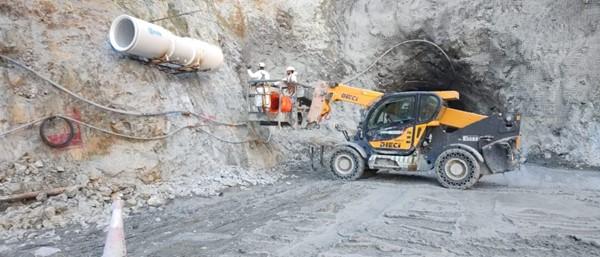

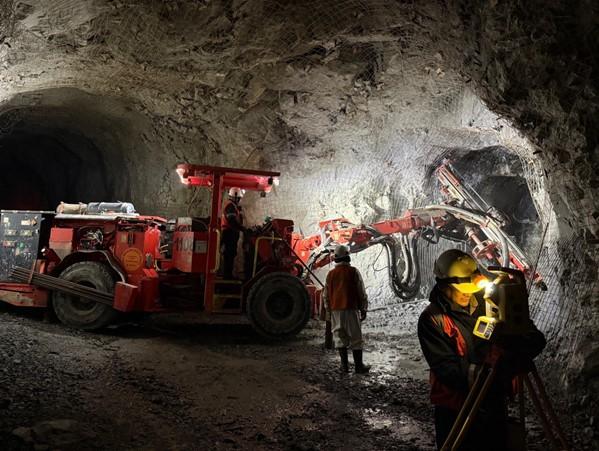

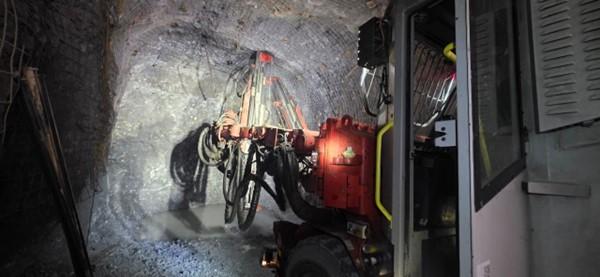

Figure 1,2 & 3. Underground development at Paloma
Minera Don Nicolas Exploration Update
The Company continues to execute its exploration program at MDN focused on targets that have the potential to materially add to mine life. Throughout the Company’s expansive land package, several high priority targets were identified within each of our production capacities; namely Heap leach, Open pit and underground.
The initial focus has been in the central Paloma area, and results to date are promising with signs of potential resource expansion at two zones, although we continue to wait for full assay results. As a result, the Company recently announced the decision to add additional rigs and accelerate and expand the exploration program. In addition to the 20,000 metre program planned for 2025, an additional 50,000 metres is now planned for 2026, allowing for several high value targets to be tested simultaneously including underground exploration, all of which aim to materially expand resources at MDN and extend the mine life.
Mark Brennan, CEO and Chairman commented, “We are very pleased with the progress being made at all of our operations. After a brief delay with our new underground operations, the very positive transition year at MDN remains firmly on track. Across all production platforms, performance continues to improve — highlighted by record and growing output from the heap leach and the successful transition of underground operations to the production phase expected in the fourth quarter. With all infrastructure and the mobile fleet now fully developed, MDN is well positioned to rapidly exploit any additional resources being uncovered by our ongoing exploration program.”
He continued, “Cerrado also has made very good progress to advance both the Lagoa Salgada and Mont Sorcier projects, with completion of their respective feasibility studies targeted for Q4 2025 and Q2 2026. As these robust projects continue to be de-risked, we expect the strong underlying economics to highlight the significant value gap that exists compared to assets in their respective peer groups. We are hoping this will lead to a significant rerating for Cerrado shareholders”
Lagoa Salgada Project Update
The Company continues to advance all the required works to complete the Optimized Feasibility Study at the Highly Prospective Lagoa Salgada VMS project in Portugal. Together with our consultants, quotations for capital and operating equipment are being sourced, and the mine plan and throughput optimization are underway. The Company expects to deliver the Optimized Feasibility Study by the end of the year. During the quarter, the Company also saw the completion of the EU Undercover program, looking for deeper resource potential. Results are expected to be available in the coming months.
Mont Sorcier Project Update
At the Mont Sorcier high-purity iron project, all key workstreams continued to progress the feasibility study, and the Company completed an infill drilling program to update sufficient resources to the Proven and Probable categories. Over 17,000 metres were drilled with results to be incorporated into a new mineral reserve estimate to support the feasibility study, which is targeted for completion in Q2 2026.
The Bankable Feasibility Study aims to provide a detailed updated economic study on the potential for the project as highlighted in the previous 2022 NI 43-101 Preliminary Economic Assessment that delivered a project NPV8% of US$1.6 billion based upon iron concentrates grading 65% iron. As highlighted previously, new test work has now shown the ability to deliver a high-purity DRI-grade Iron concentrate product of over 67% iron, enhancing the projects position delivering a highly desired product to support growing demand from the Green Steel transition.
Table 1. Key Operating Information
Key Operating Information | ||||||||||
2024 | Jan to Dec, | 2025 | 2025 | |||||||
Operating Data | Unit | Q1 2024 | Q2 2024 | Q3 2024 | Q4 2024 | 2024 | Q1 2025 | Q2 2025 | Q3 2025 | Jan to Sept |
Heap Leach Operations | ||||||||||
Ore Mined | ktonnes | 144 | 207 | 365 | 563 | 1,280 | 659 | 550 | 759 | 1,968 |
Waste Mined | ktonnes | 519 | 708 | 885 | 1,103 | 3,215 | 1,024 | 998 | 1,001 | 3,024 |
Total Mined | ktonnes | 663 | 915 | 1,250 | 1,666 | 4,494 | 1,683 | 1,549 | 1,760 | 4,992 |
Strip ratio | waste/ore | 3.60 | 3.42 | 2.43 | 1.96 | 2.51 | 1.56 | 1.81 | 1.32 | 1.54 |
Mining rate | tpd | 7,369 | 10,058 | 13,583 | 18,112 | 12,313 | 18,699 | 17,207 | 19,133 | 18,352 |
Ore PAD Feed | Ktonnes | 231 | 285 | 434 | 588 | 1,538 | 693 | 724 | 793 | 2,210 |
Head Grade Au | g/t | 0.59 | 0.85 | 0.75 | 0.73 | 0.73 | 0.80 | 0.86 | 0.81 | 0.82 |
Head Grade Ag | g/t | 9.82 | 12.39 | 10.04 | 9.96 | 10.41 | 15.95 | 12.13 | 11.68 | 13.17 |
Recovery Au | % | 25% | 29% | 31% | 41% | 34% | 39% | 37% | 47% | 41% |
Recovery Ag | % | 3% | 9% | 9% | 15% | 10% | 8% | 15% | 23% | 15% |
PAD Throughput | tpd | 2,565 | 3,134 | 4,715 | 6,394 | 4,214 | 7,700 | 7,953 | 8,621 | 7,700 |
Gold ounces produced | oz | 1,103 | 2,290 | 3,253 | 5,631 | 12,277 | 6,897 | 7,442 | 9,675 | 24,014 |
Silver equivalent ounces produced | oz | 29 | 130 | 150 | 325 | 633 | 331 | 422 | 790 | 1,543 |
Gold Geo Produced | oz | 1,132 | 2,420 | 3,403 | 5,956 | 12,911 | 7,228 | 7,864 | 10,465 | 25,557 |
High Grade CIL Operations | ||||||||||
Ore Mined | ktonnes | 85 | 58 | 43 | 31 | 218 | 11 | – | – | 11 |
Waste Mined | ktonnes | 2,099 | 1,083 | 1,235 | 610 | 5,027 | 60 | – | – | 60 |
Total Mined | ktonnes | 2,184 | 1,142 | 1,278 | 641 | 5,245 | 71 | – | – | 71 |
Strip ratio | waste/ore | 24.61 | 18.56 | 28.44 | 19.87 | 23.08 | 5.23 | 5.23 | ||
Mining rate | tpd | 24,264 | 12,546 | 13,896 | 6,966 | 14,369 | 788 | – | – | 261 |
Ore Milled | Ktonnes | 90 | 66 | 99 | 93 | 348 | 92 | 97 | 93 | 281 |
Head Grade Au | g/t | 3.65 | 7.08 | 4.58 | 1.48 | 3.99 | 1.51 | 1.18 | 1.31 | 1.33 |
Head Grade Ag | g/t | 10.21 | 12.86 | 7.86 | 8.13 | 9.49 | 6.44 | 9.71 | 7.98 | 8.08 |
Recovery Au | % | 88% | 91% | 92% | 90% | 90% | 92% | 84% | 86% | 88% |
Recovery Ag | % | 56% | 54% | 63% | 64% | 59% | 54% | 62% | 55% | 58% |
Mill Throughput | tpd | 1,001 | 725 | 1,072 | 1,010 | 952 | 1,017 | 1,076 | 1,006 | 1,033 |
Gold ounces produced | oz | 9,879 | 13,648 | 13,022 | 4,312 | 40,861 | 3,821 | 3,378 | 3,253 | 10,452 |
Silver equivalent ounces produced | oz | 193 | 187 | 179 | 163 | 722 | 115 | 195 | 150 | 460 |
Gold Geo Produced | oz | 10,072 | 13,835 | 13,201 | 4,475 | 41,583 | 3,936 | 3,573 | 3,403 | 10,912 |
Consolidated Gold Production | ||||||||||
Gold Geo Produced | oz | 11,204 | 16,255 | 16,604 | 10,431 | 54,494 | 11,163 | 11,437 | 13,868 | 36,469 |
Gold Geo Sold | oz | 10,331 | 15,775 | 15,844 | 10,108 | 52,058 | 11,468 | 10,886 | 12,957 | 35,311 |
Average realized price per gold ounce sold | $/oz | 1,970 | 2,199 | 2,329 | 2,371 | 2,226 | 2,520 | 2,684 | 3,153 | 2,801 |
